Backlog and sprints

Remarque

The Backlogs module is getting a reset with OpenProject 17.3 release and will undergo further changes in the upcoming versions. We will keep updating the documentation over time to reflect these changes.

Working in agile project teams is becoming increasingly important, and with OpenProject, it is easier than ever.

OpenProject supports your work with the Agile and Scrum methodology by providing a variety of improved functionalities. You can now create and manage sprints, record and prioritize user stories in sprints and the backlog, use sprint boards or burndown-charts, print story cards, and much more. Pour plus d’informations, veuillez vous référer à la page OpenProject fonctionnalités Agile et Scrum.

A Backlog is defined as a plugin that allows you to use the backlogs feature in OpenProject. In order to use backlogs in a project, the Backlogs module has to be activated in the project settings.

Please note that this user guide does not represent an introduction to Scrum methodology, but merely explains the Scrum-related functionalities and user instructions in OpenProject.

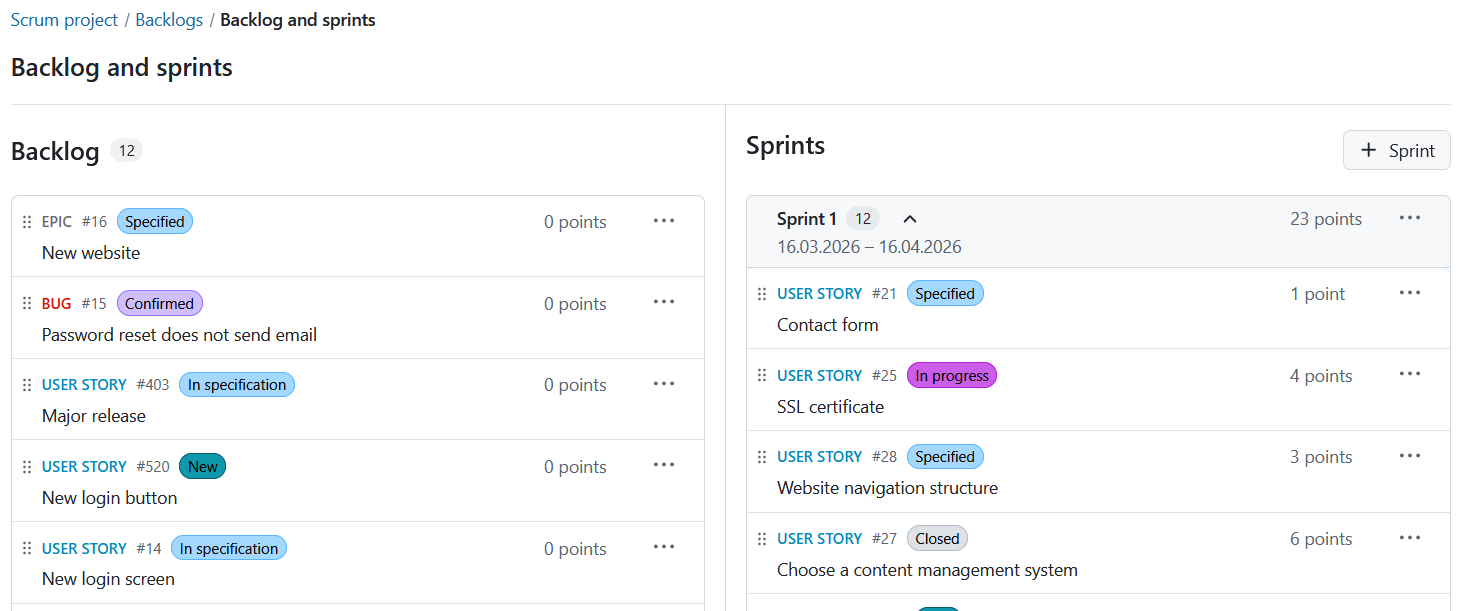

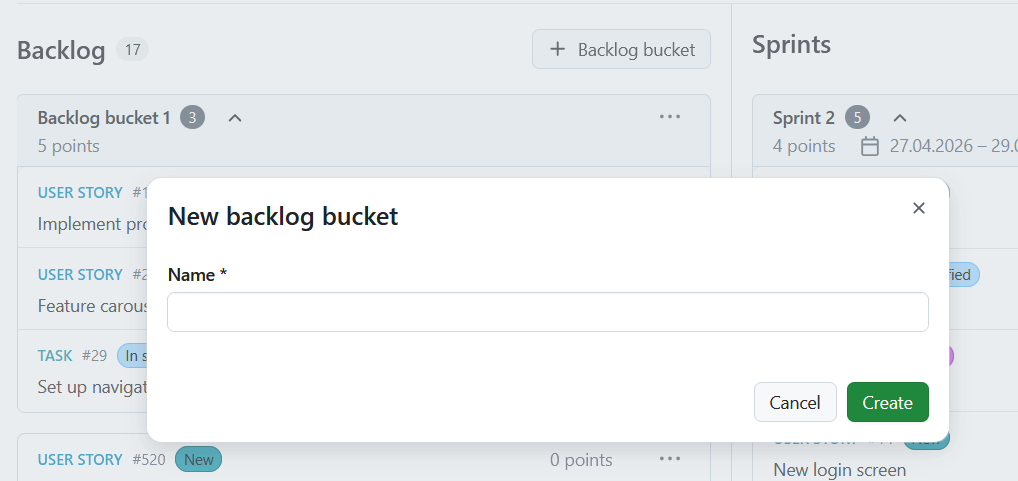

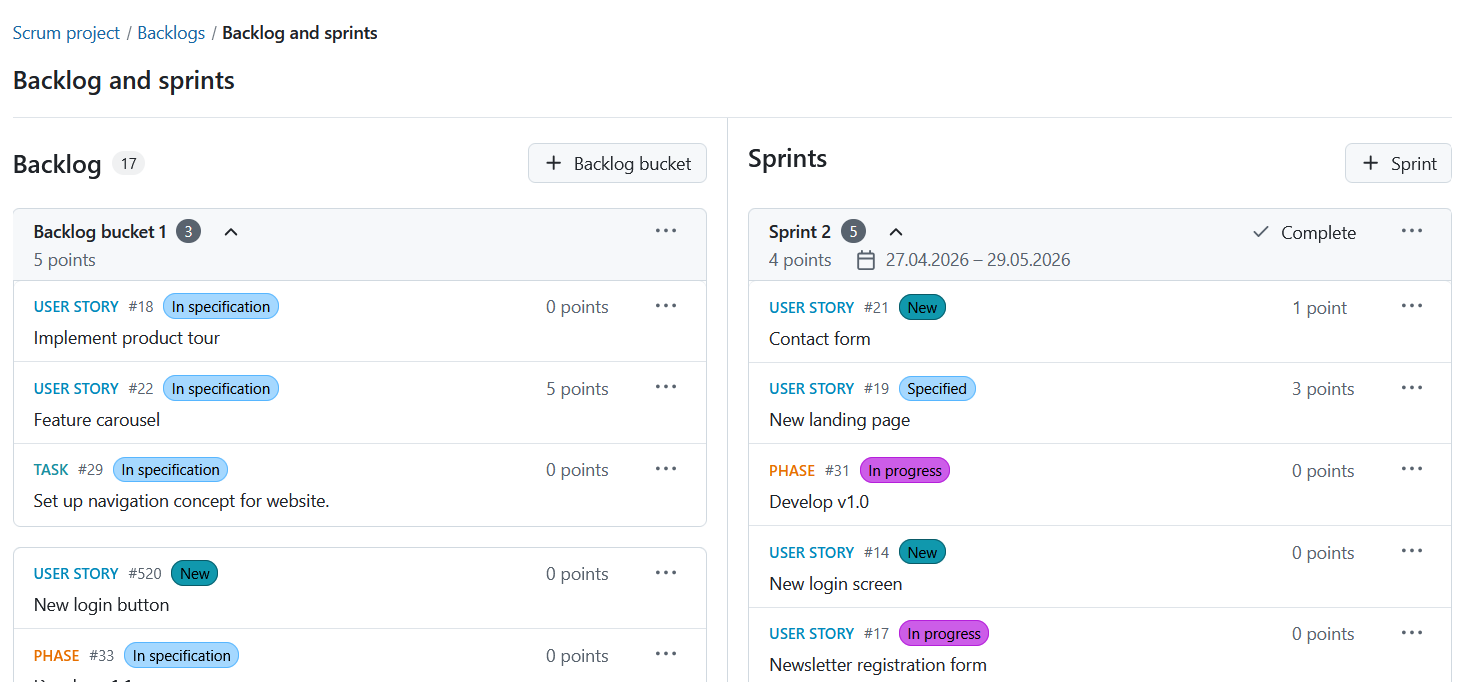

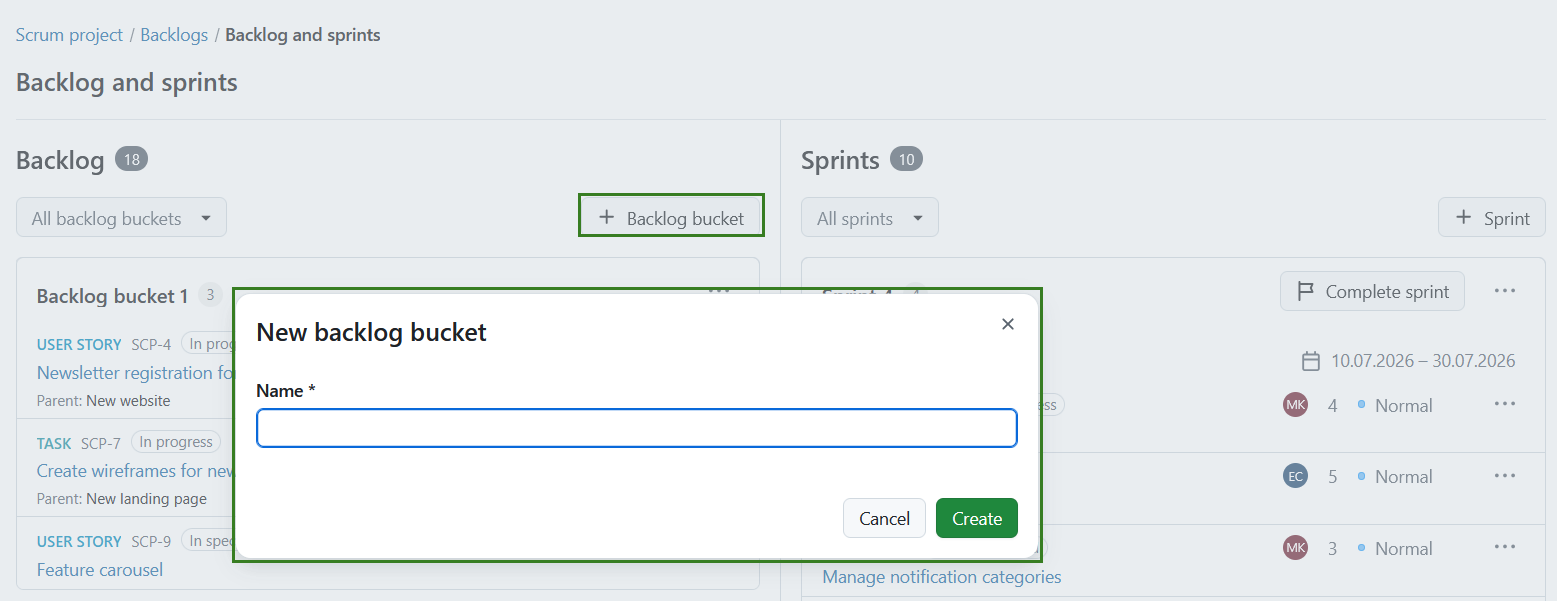

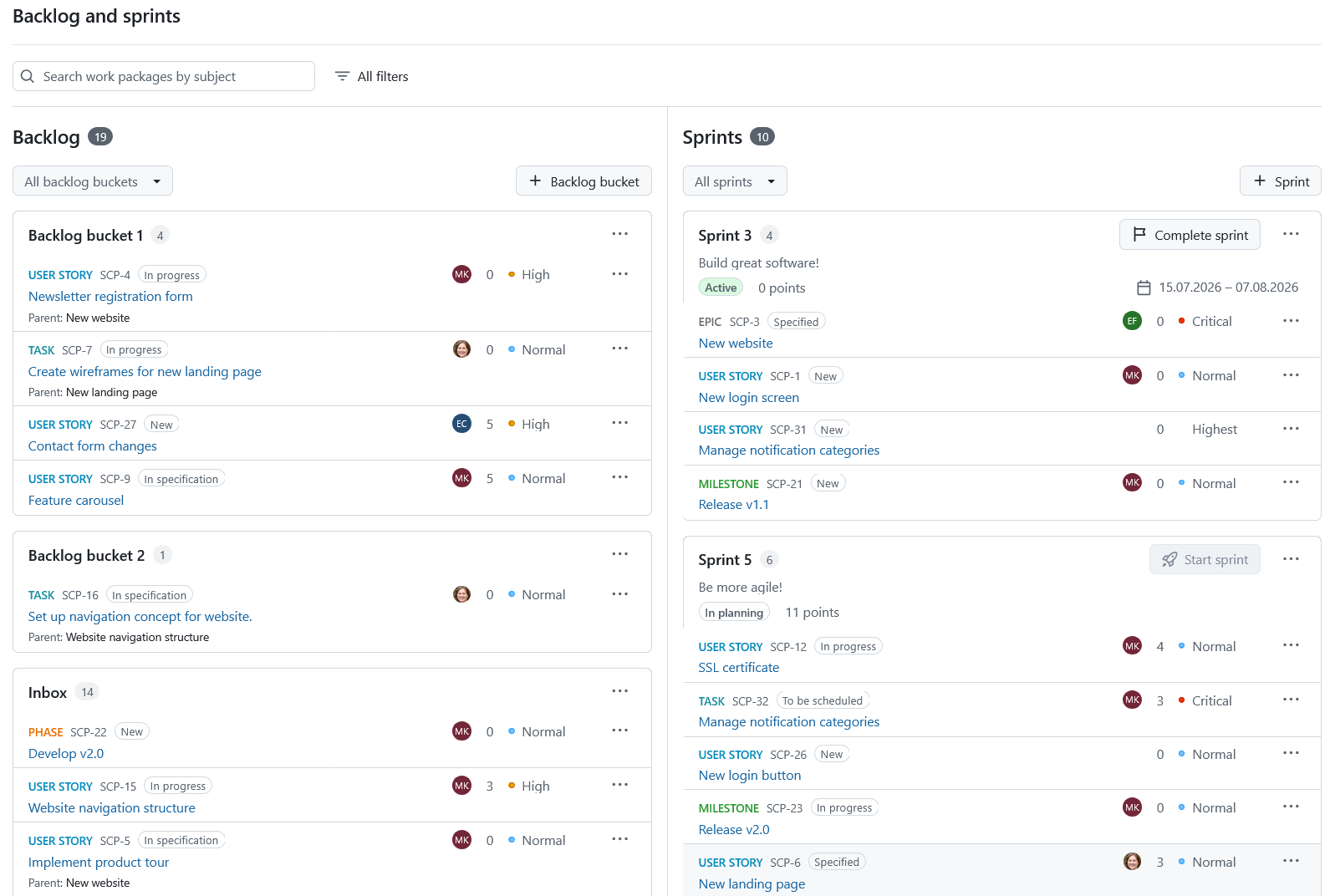

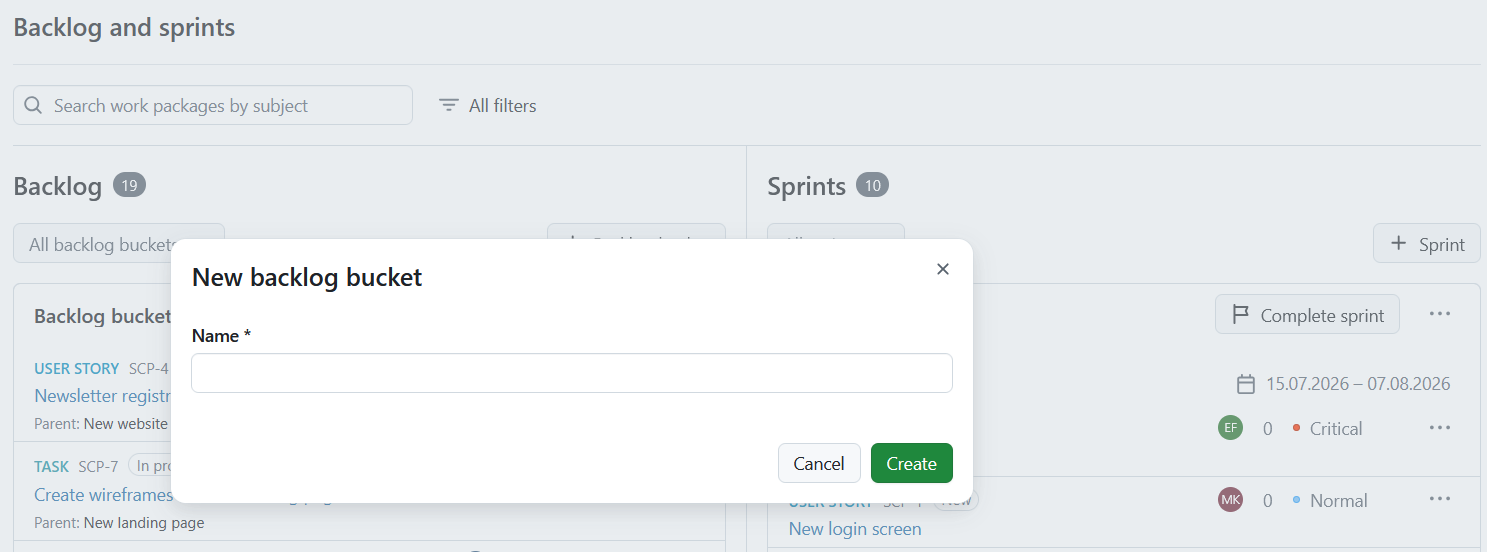

Backlogs module in OpenProject showing backlog items and multiple sprints with work packages

Manage the backlog

The Backlog is automatically populated based on the work packages in a project that are not yet in sprints. When you add a work package to a sprint, or close it, the work package will no longer be visible in the backlog.

When there are too many items in the Backlog, a Show more items link appears in the middle. This compacts the middle section so that you always see the top and the bottom of the backlog.

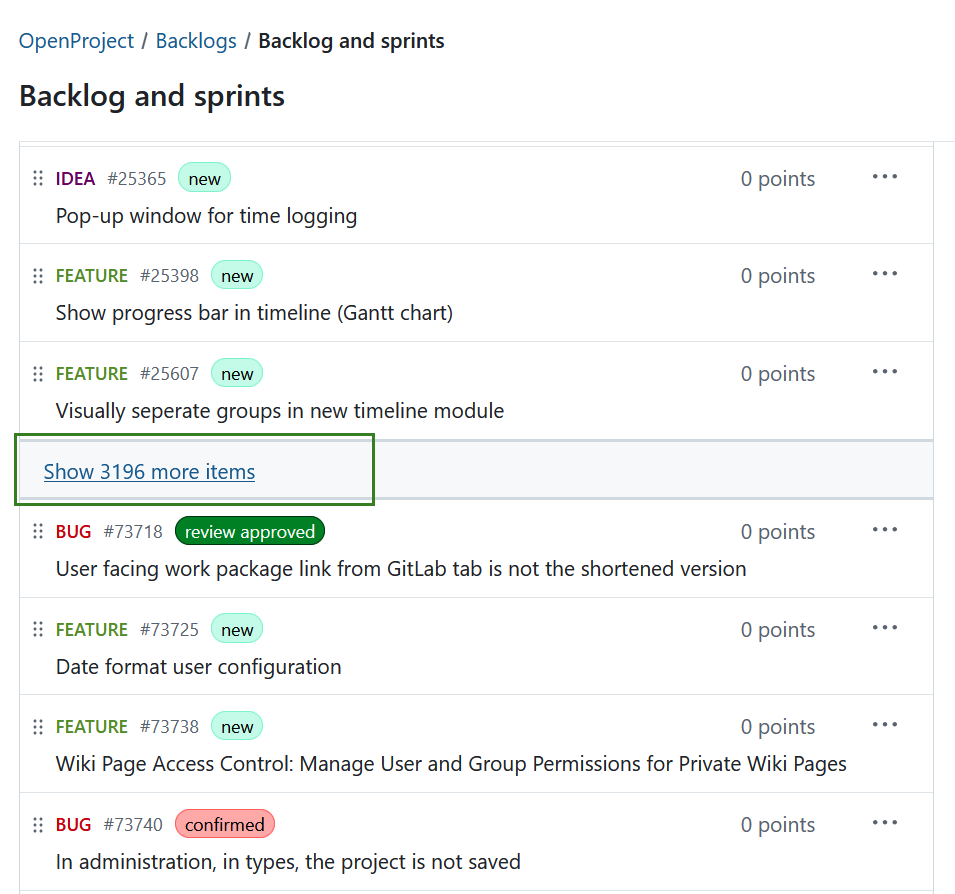

Backlog view with many items collapsed behind a “Show more items” link in the middle

Next to every work package listed in the backlog or sprint, you can access the More (three dots) menu, including the following options:

  • Open details view or fullscreen view of a work package. These options allow you to choose how much information (about the backlog item) you’d like to be displayed.
  • Copy the work package URL or ID to the clipboard.
  • Move a work package.

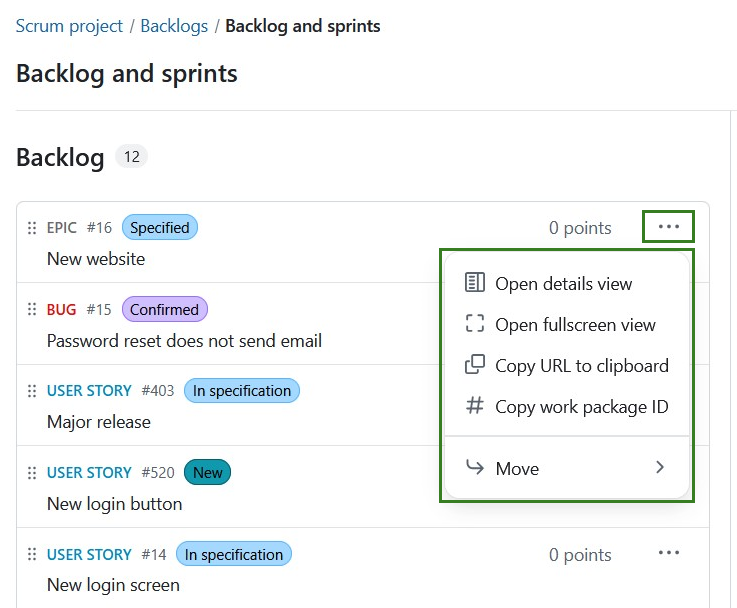

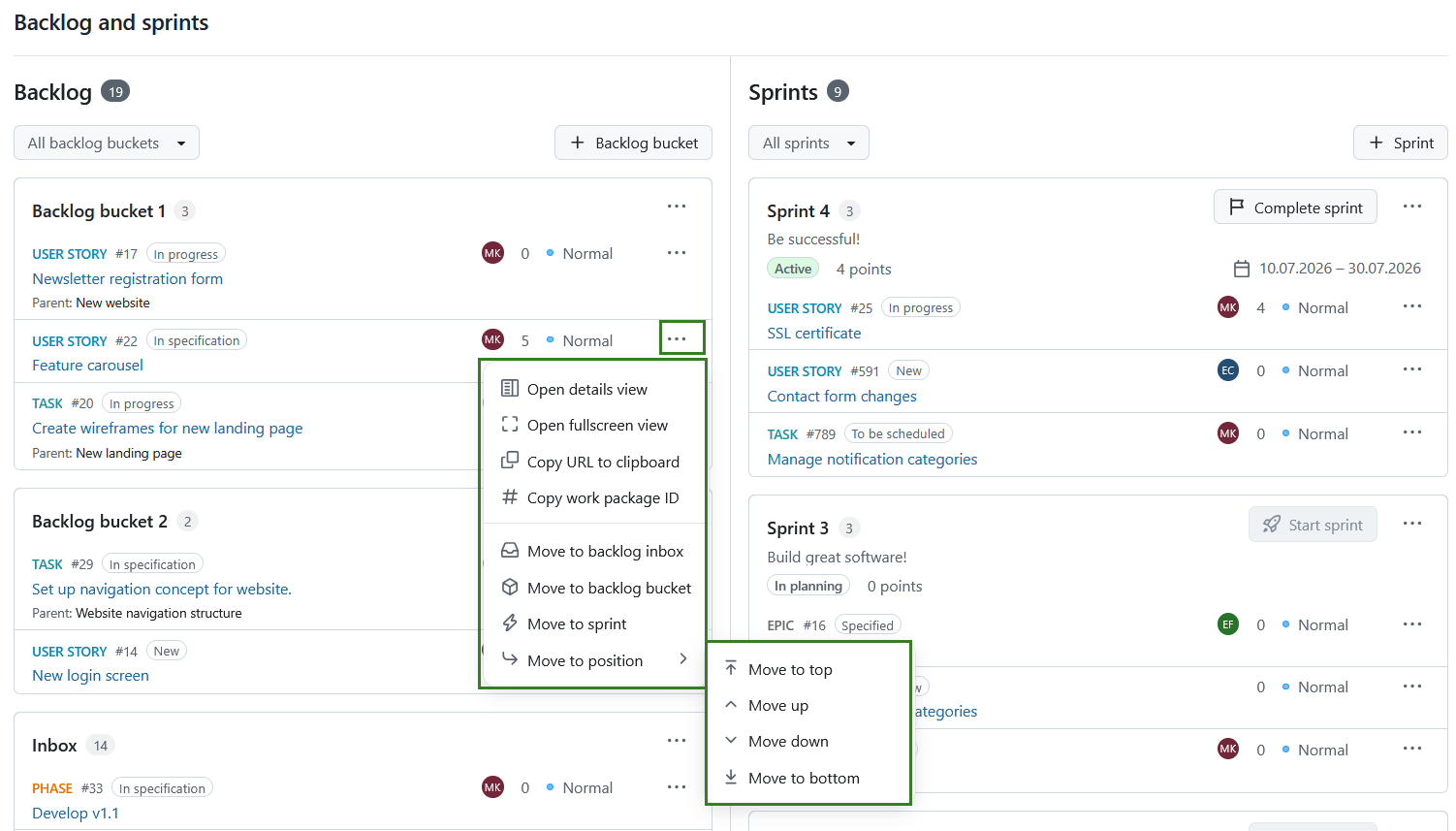

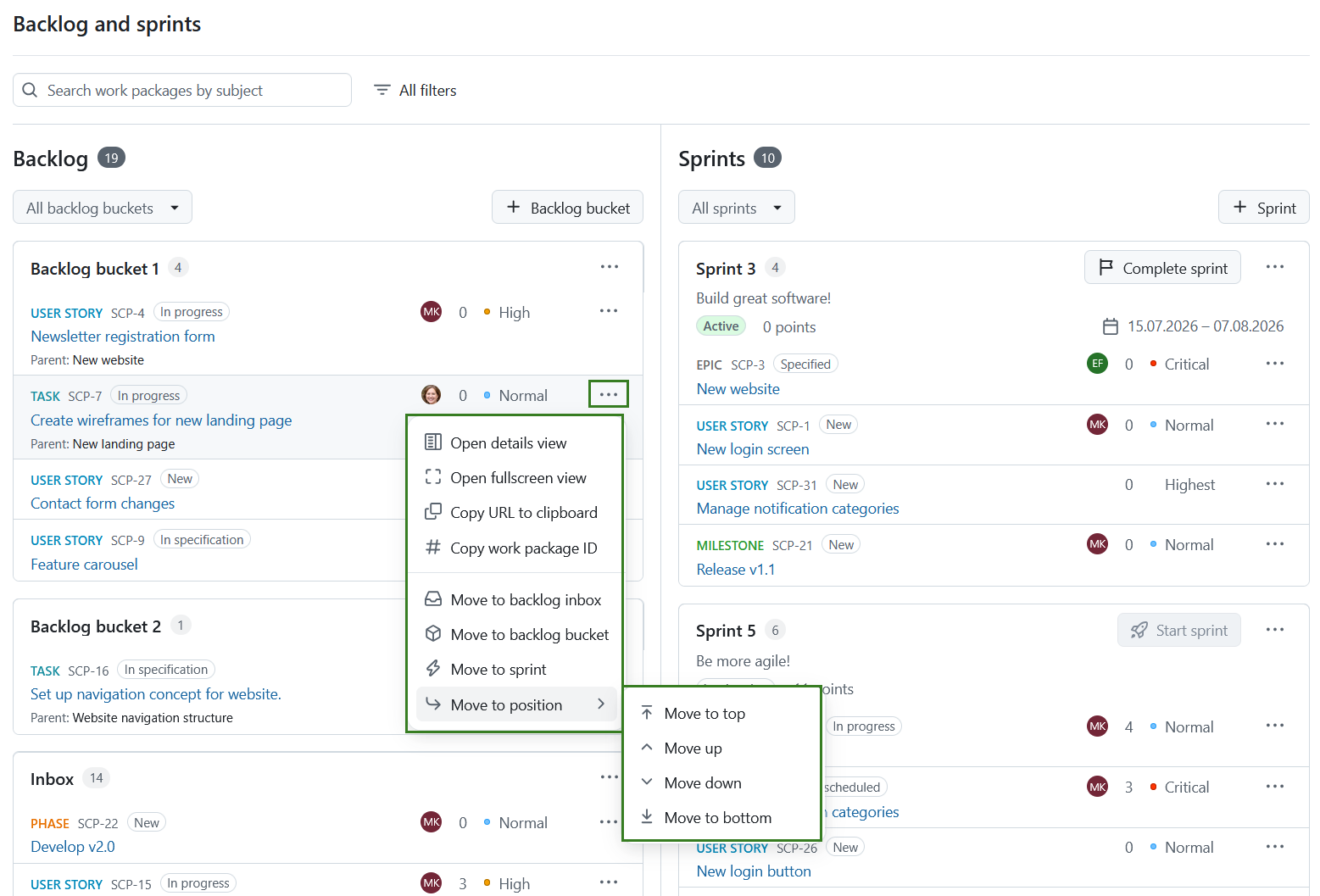

Backlog work package menu with options like details view, copy link, and move

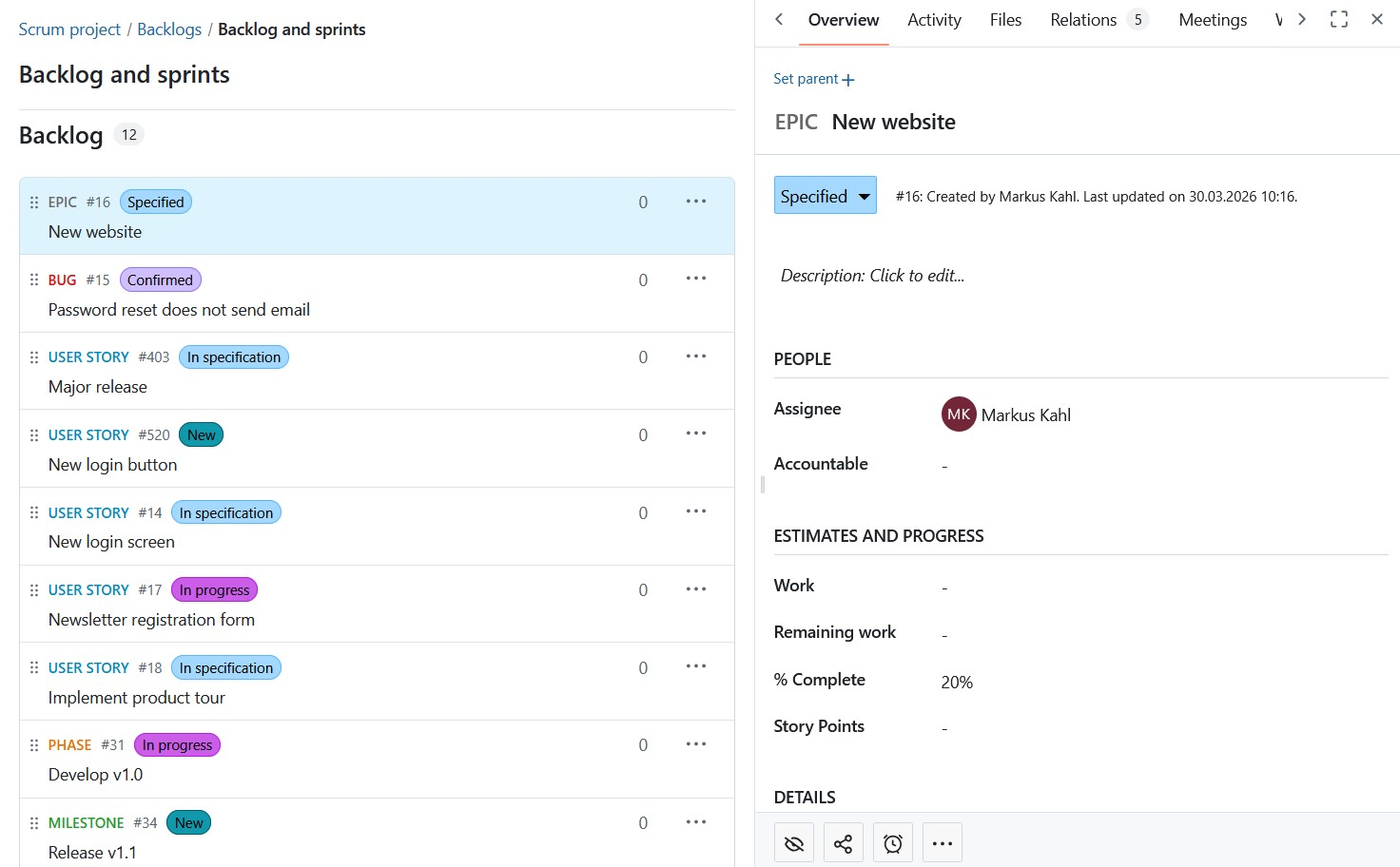

Details view opens the work package information on the right side, the same way as in the notifications center.

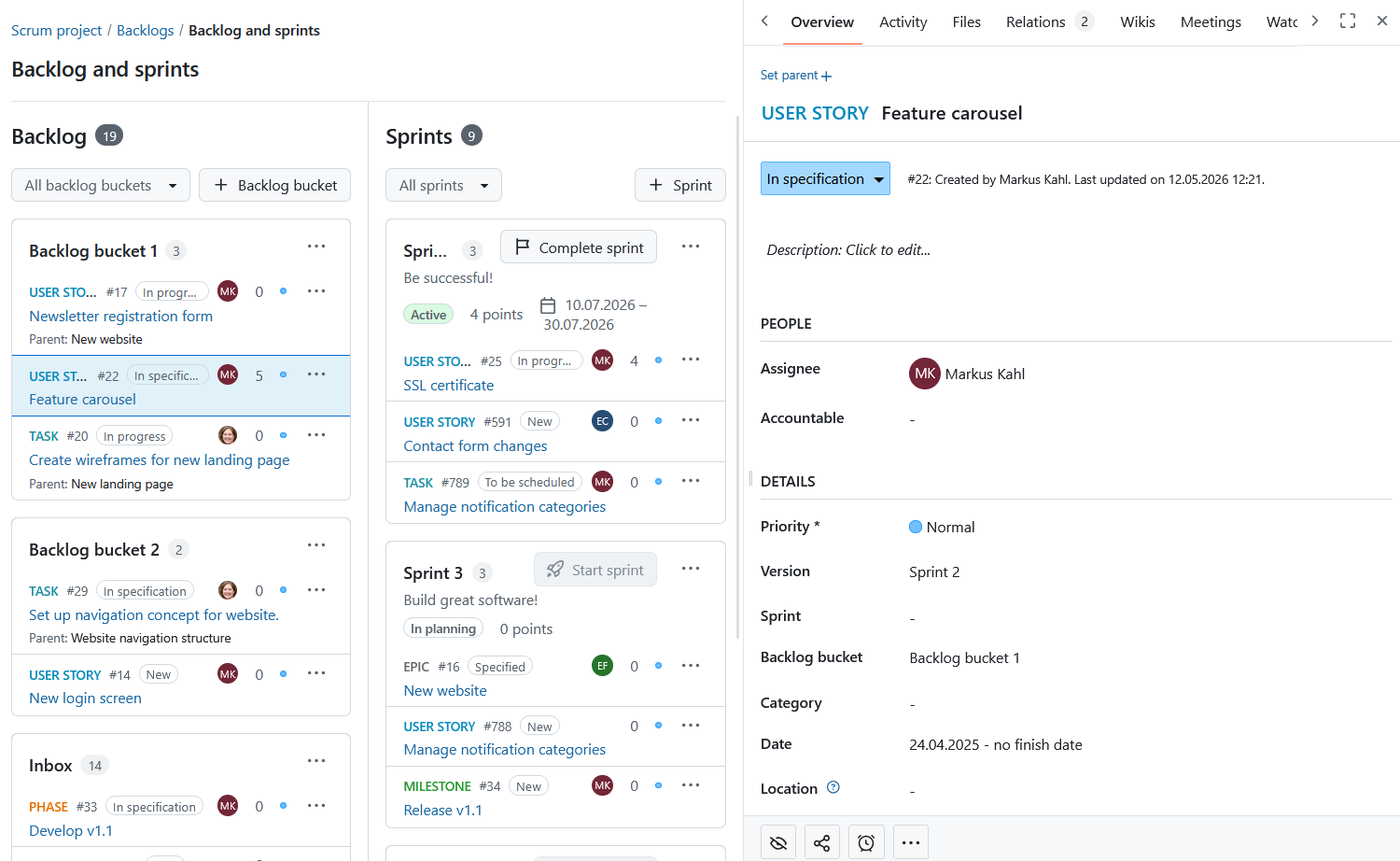

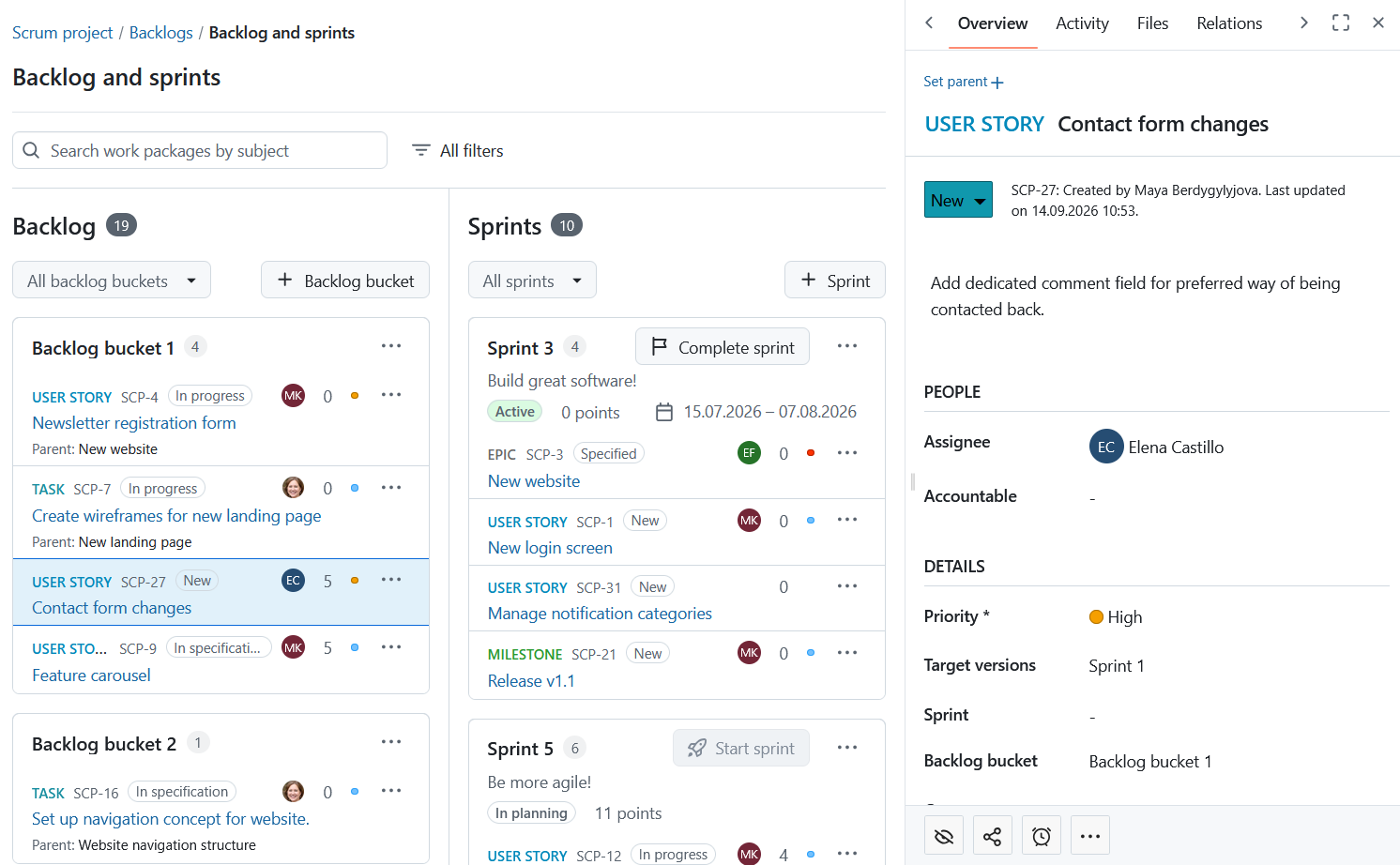

Backlog item opened in details view on the right side panel

Opening the fullscreen view opens the work package in fullscreen.

Work package opened in fullscreen in OpenProject

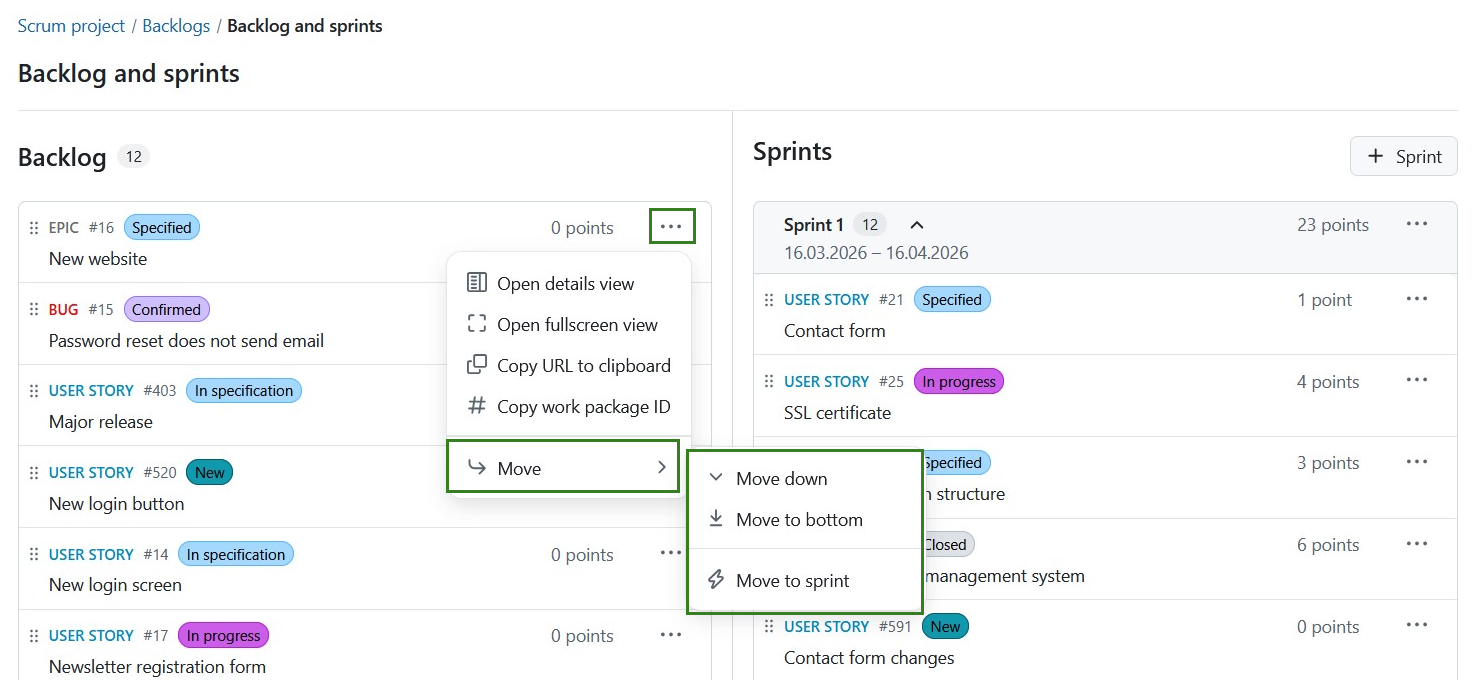

With the Move option, you can order items according to your preference within the backlog or move them to a sprint. You can also drag and drop the work packages.

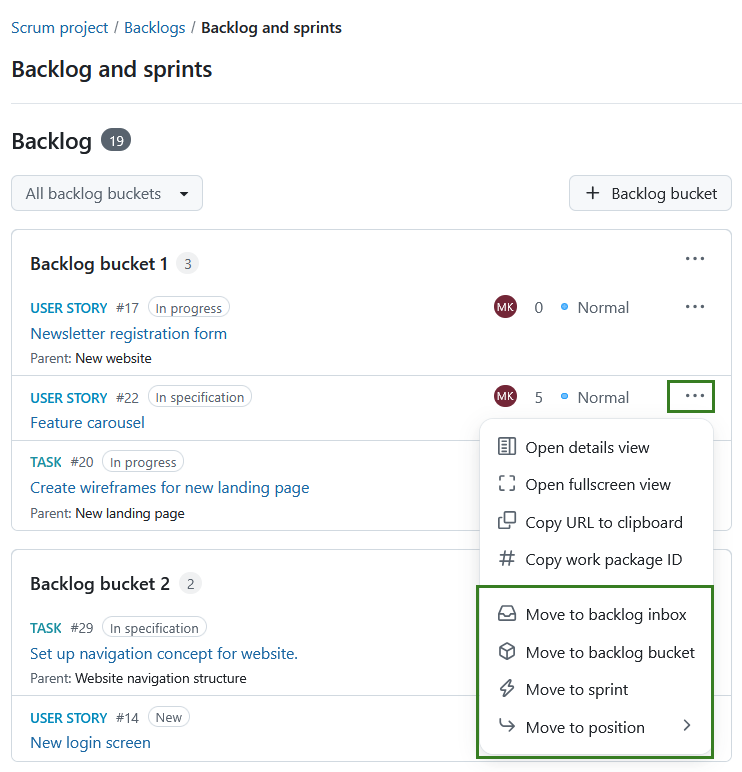

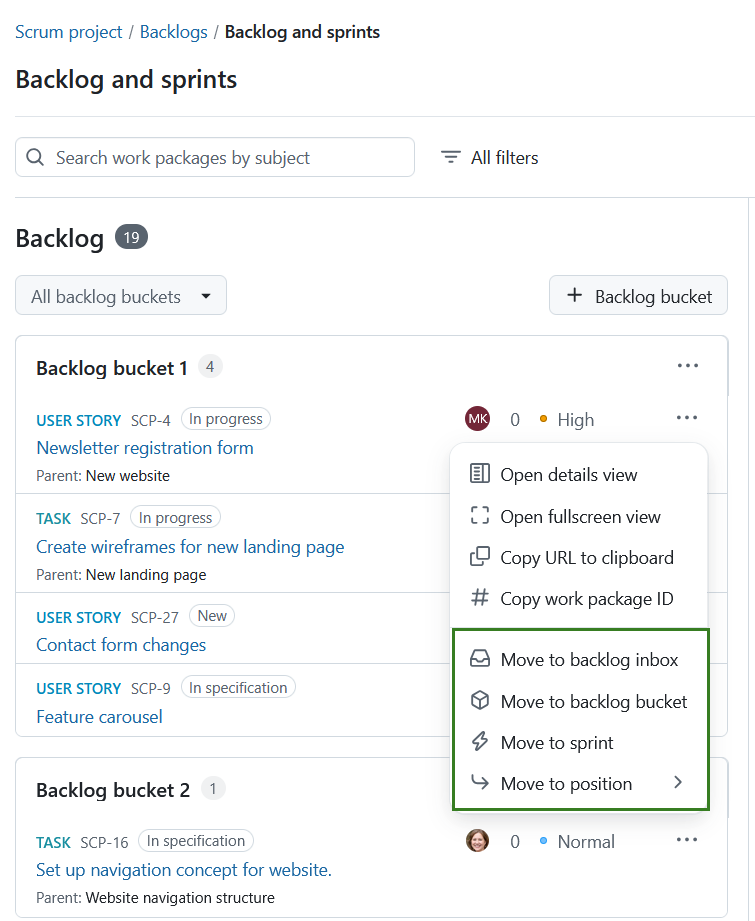

Move options menu for a backlog item showing reorder and sprint assignment options

Create and manage sprints

Important

Starting with the OpenProject 17.3 release, Sprints are new objects no longer linked to versions (as was the case with previous OpenProject versions).

A Sprint is a planned and time-boxed period in which a Scrum team completes a defined set of tasks. They are containers or buckets where work packages can be manually added or removed from the Backlog via a drag-and-drop icon.

Create a sprint

To create a sprint, click the + Sprint button in the top right corner of the Backlogs module. This opens up a form for you to fill in details about the sprint name, start date, and completion date. The duration is automatically calculated. Click the Create button to proceed.

The naming of sprints is number-based by default (e.g. Sprint 1, Sprint 2). These names can be edited according to your team’s work rhythm.

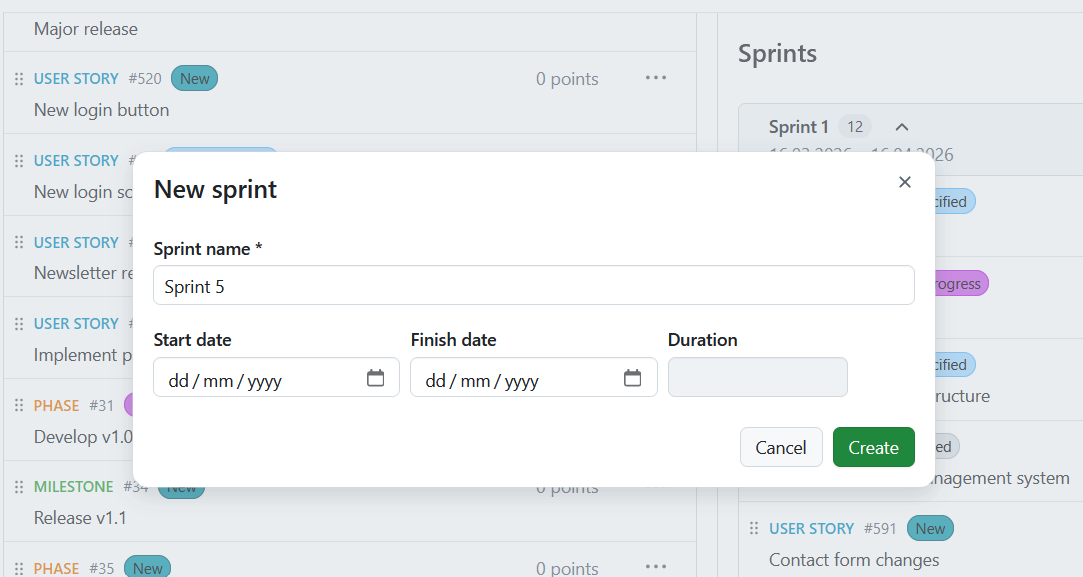

Sprint creation form with fields for name, start date, and end date

Start or complete a sprint

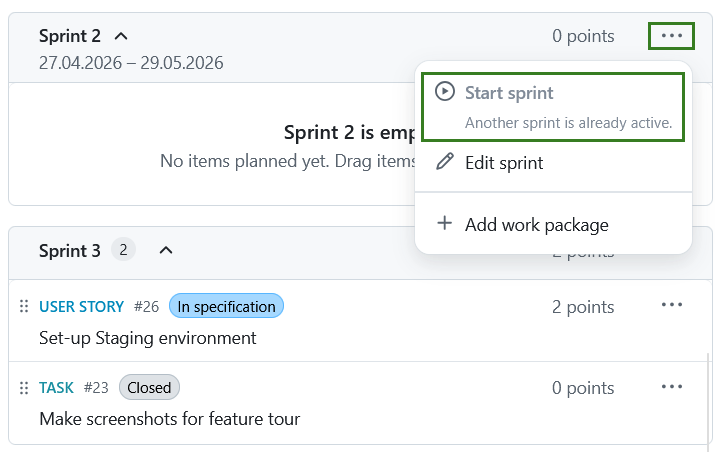

Your sprint is set in motion by clicking the Start sprint button. Clicking it will open the sprint board.

Remarque

A sprint cannot be started if another sprint is already in progress. In this case the button will be disabled.

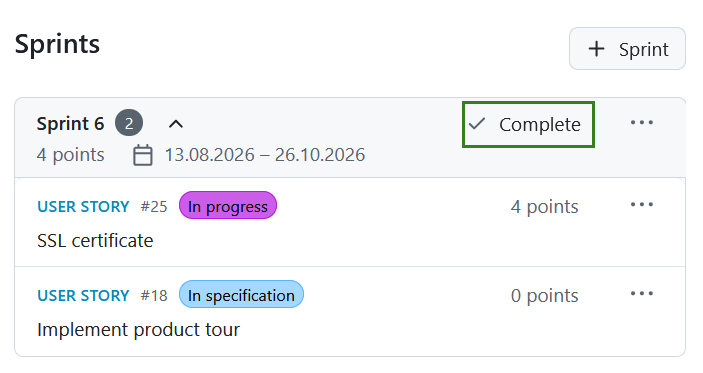

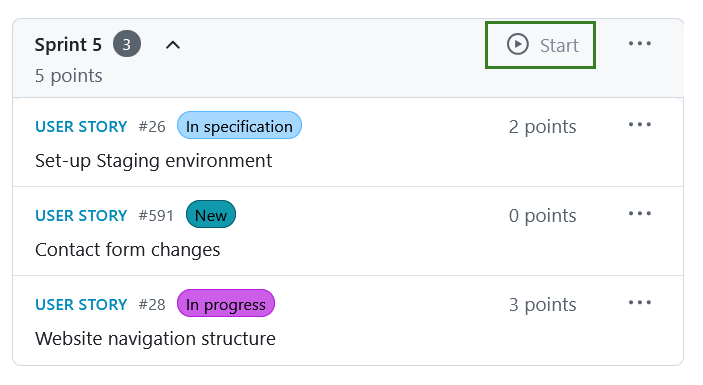

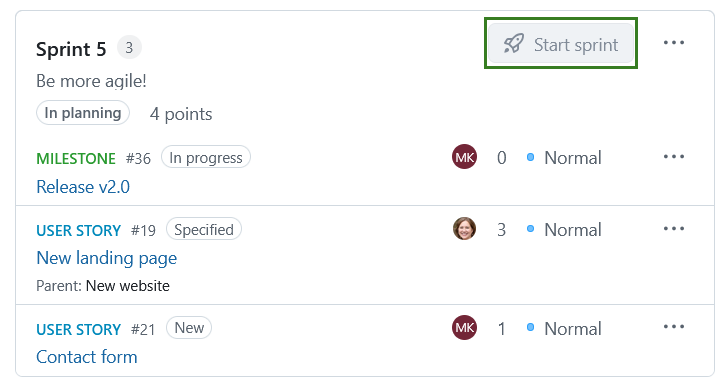

Start sprint button in the Backlogs module interface

Once a sprint has started, it is considered active and can be managed through the Sprint menu options, which include:

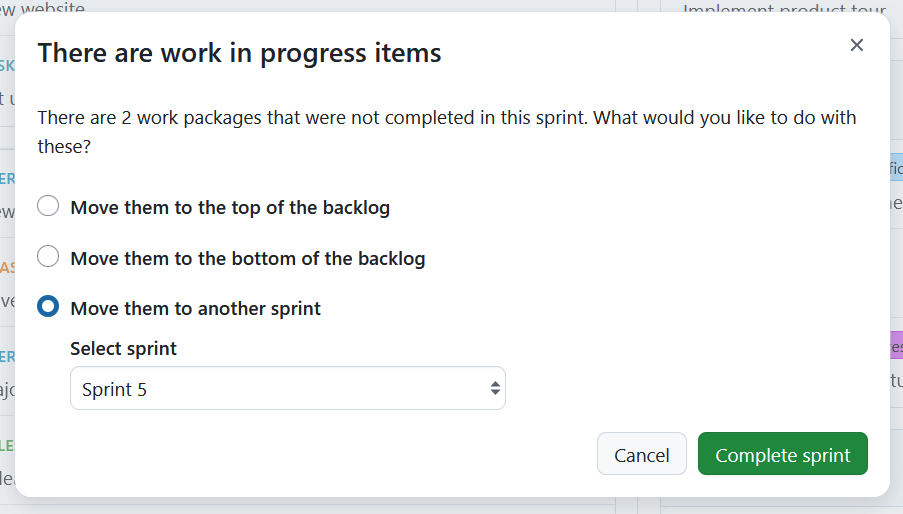

  • Complete sprint
  • Edit sprint
  • Add work package
  • Open a Sprint board
  • Graphique burndown

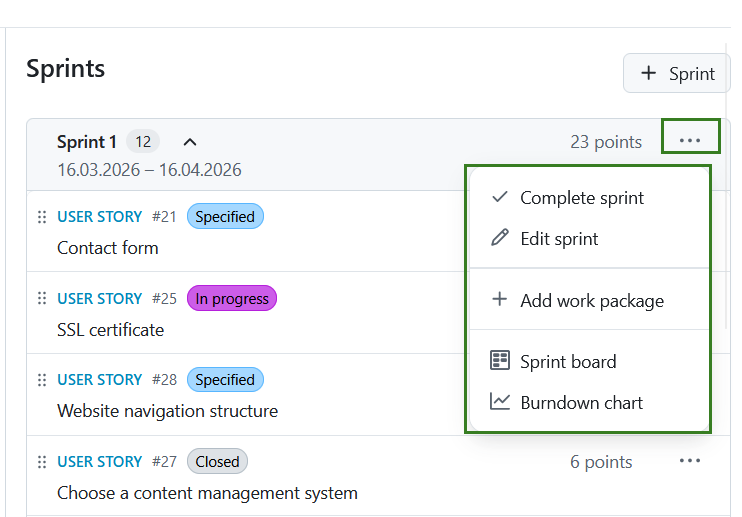

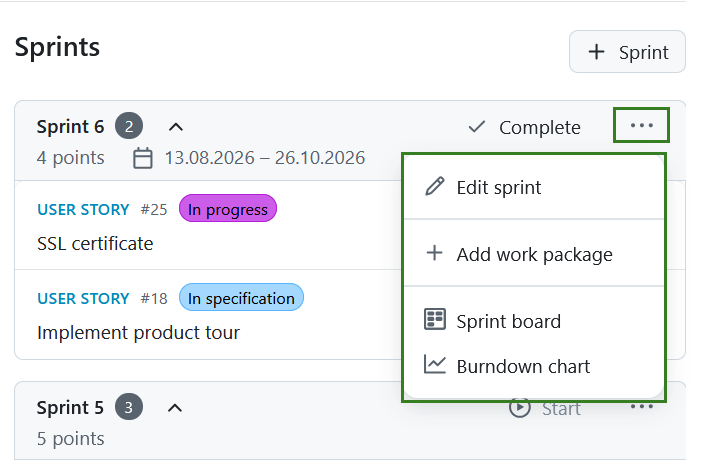

Sprint menu with options like edit sprint, add work package, board, and burndown chart

Add a work package

In order to create a new work package in the Backlogs module, click on the More (three dots) icon in the top right corner of a Sprint and choose + Add work package from the drop-down menu.

Une boîte de dialogue apparaît pour créer un nouveau lot de travaux. Here, you directly specify the work package type, subject, and description. Cliquez sur Créer pour continuer.

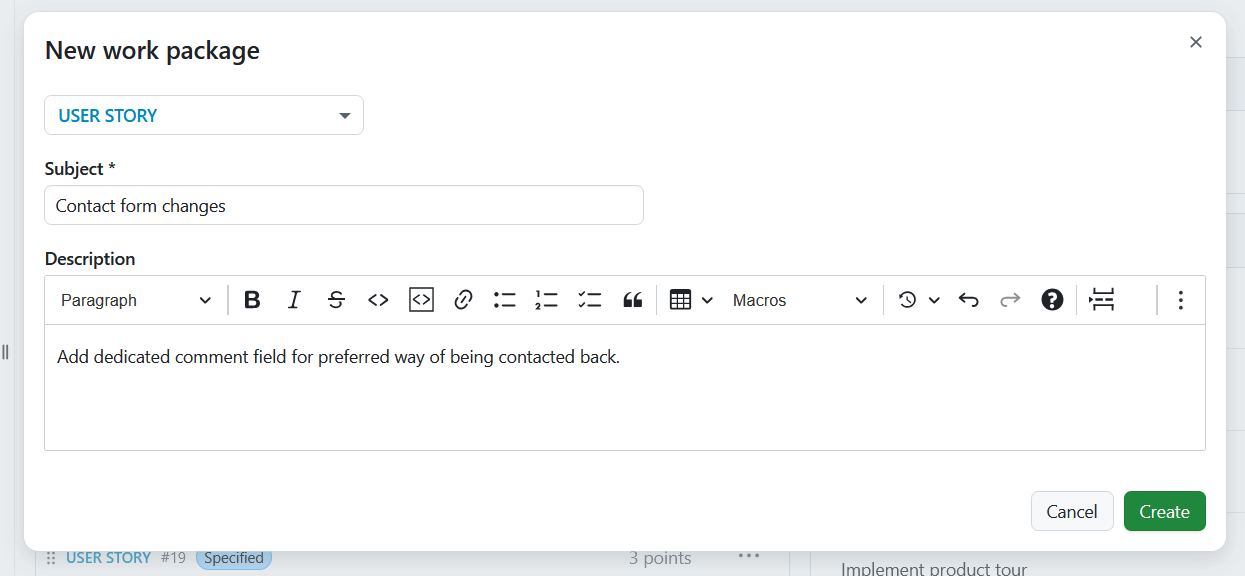

A new work package added to a sprint directly in OpenProject Backlogs module

Un nouvel élément sera ajouté au backlog pour afficher la nouvelle story créée.

Prioritize stories

You can prioritize different work packages within a backlog or sprint by either using the Move option or by dragging & dropping them. This allows you to assign work packages to a specific sprint, return to a backlog or re-order them within a sprint.

Story points

Dans un sprint, vous pouvez documenter directement l’effort nécessaire en tant que story points. The overall effort for a sprint is automatically calculated, and the sum of story points is displayed in the top row.

Story points are defined as numbers assigned to a work package used to estimate (relatively) the size of the work.

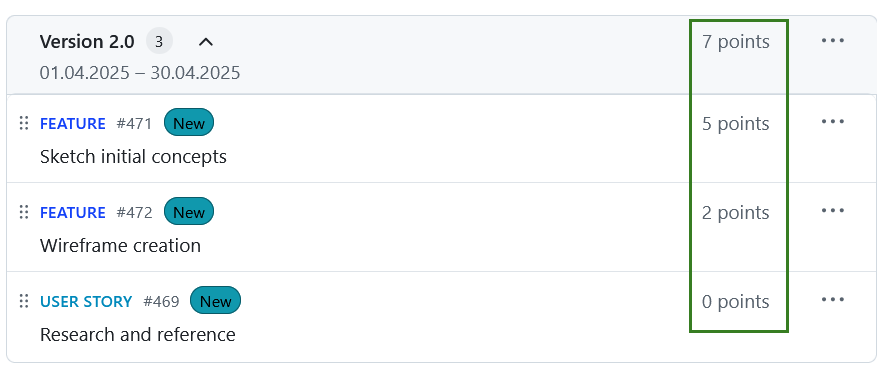

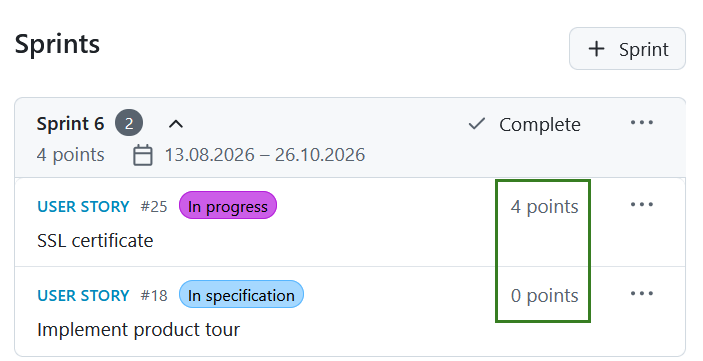

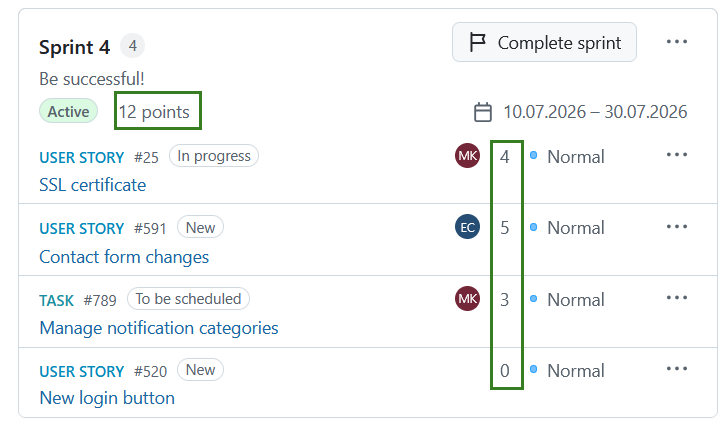

Story points assigned to work packages in a sprint in OpenProject backlogs module

You can edit story points directly from the backlogs view. In order to do so, simply click the work package you want to edit and make the desired changes in the detailed view of the work package that will open on the right.

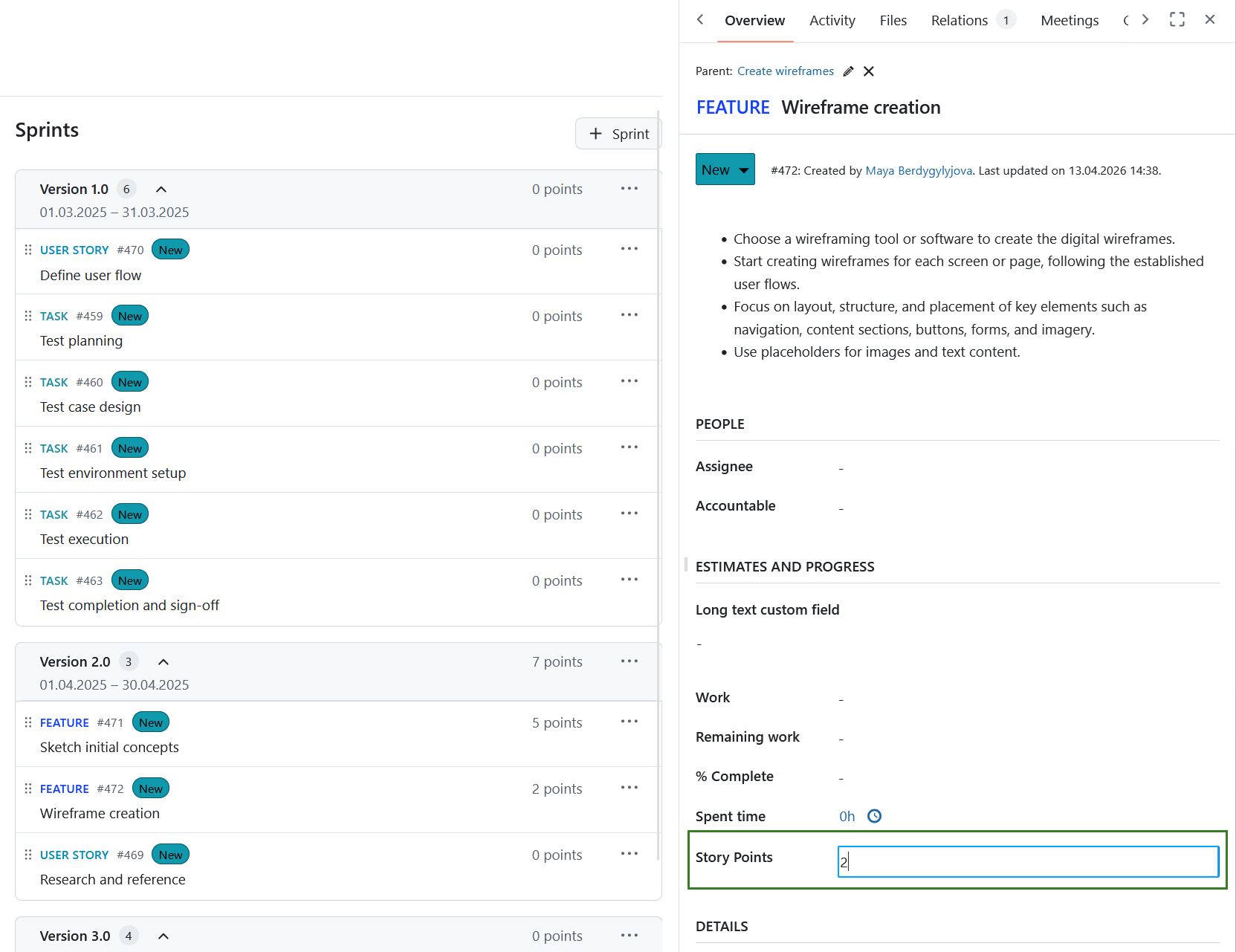

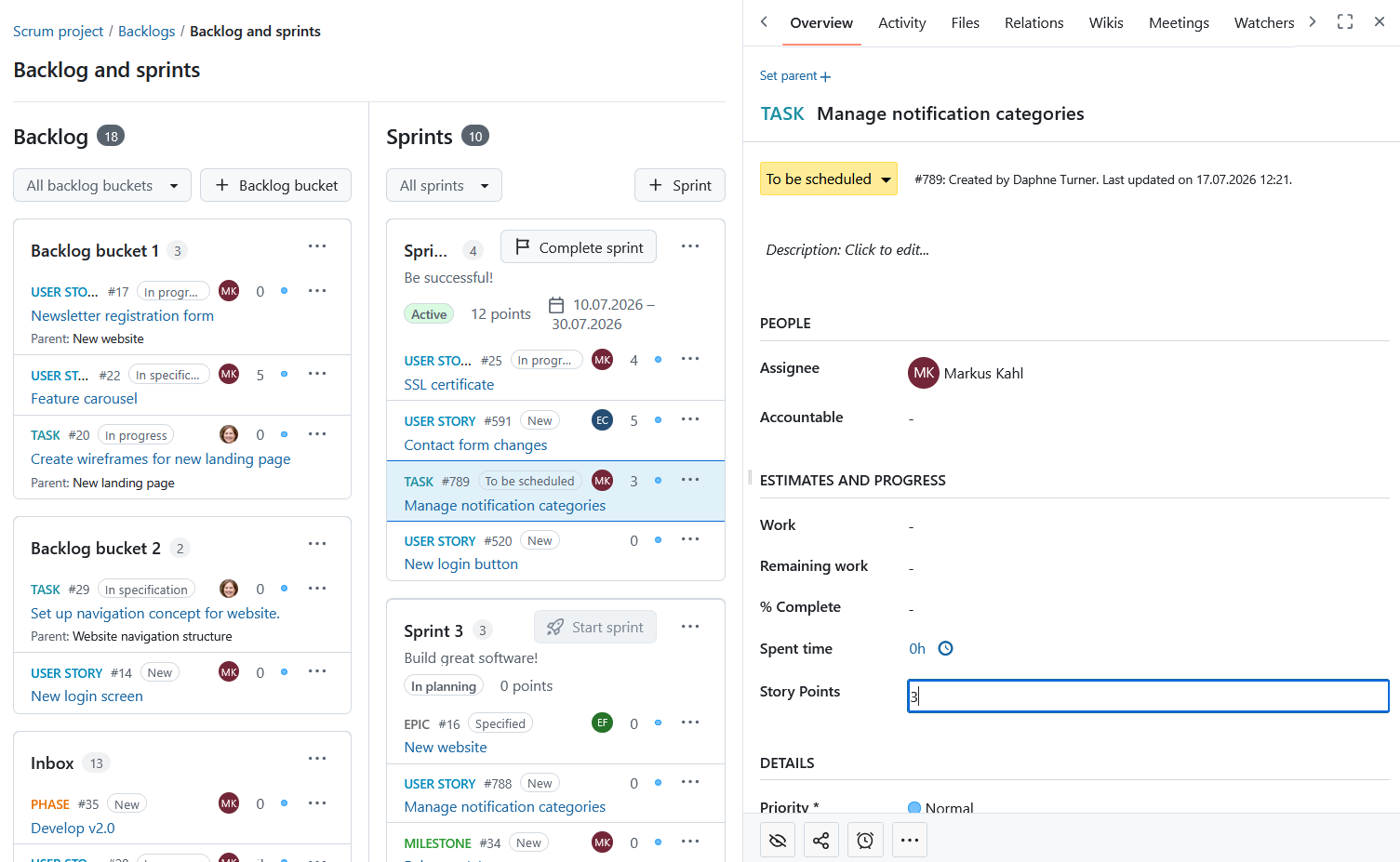

Edit story points for a work package in the Backlogs module in OpenProject

Sprint boards

Sprint boards are especially helpful for teams to track and visualize progress from the start. When you click the Start sprint within the Backlog, a dedicated sprint board is automatically created and you are forwarded to the active sprint board.

Boards are named using this pattern: [Project name: Sprint name]. As an example: Scrum project: Sprint 1.

The sprint board inherits project permissions automatically, which means it is accessible to all project members by default.

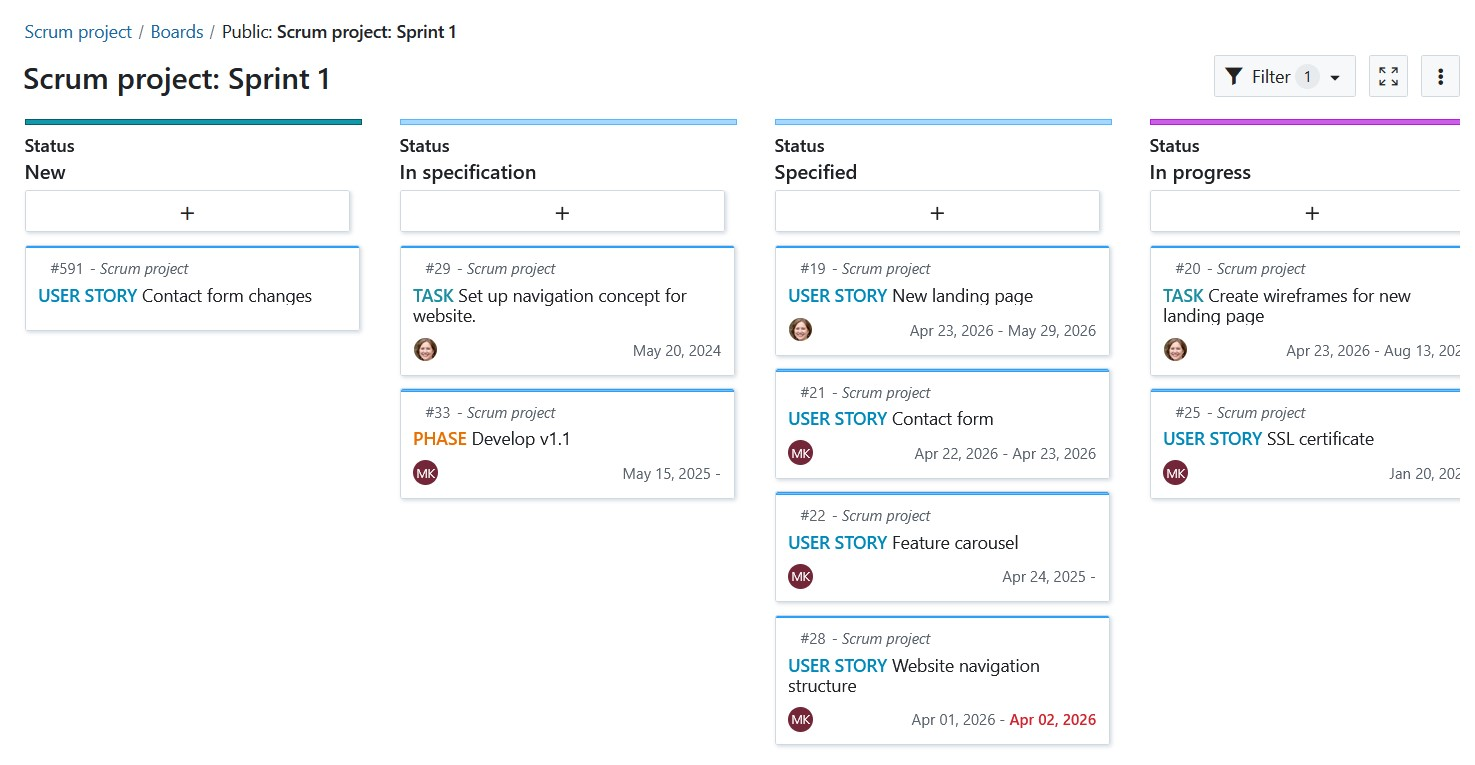

Sprint board showing work packages organized in columns to track progress

Remarque

The sprint board and burndown chart are only visible on the menu when a sprint is active.

Burndown charts

Les graphiques burndown sont un outil utile pour visualiser le burndown d’un sprint. Avec OpenProject, vous pouvez générer automatiquement des graphiques burndown des sprints et des tâches.

Conseil

As a precondition, the sprint’s start and end date must be defined and the information on story points should be well maintained.

Le burndown du sprint est calculé à partir de la somme des story points estimés. Si une user story est définie comme « fermée » (ou un autre statut qui est défini comme fermé (voir les paramètres d’administration)), elle est prise en compte pour le burndown.

Le burndown d’une tâche est calculé à partir de l’estimation du nombre d’heures nécessaires à la réalisation de cette tâche. Si une tâche est définie comme « fermée », le burndown est ajusté.

Les story points restants par sprint sont affichés dans le graphique. Facultativement, l’avancement idéal peut être affiché à titre de référence. Le burndown idéal suppose une réalisation linéaire des story points du début à la fin d’un sprint.

An example of a burndown chart in OpenProject
